28

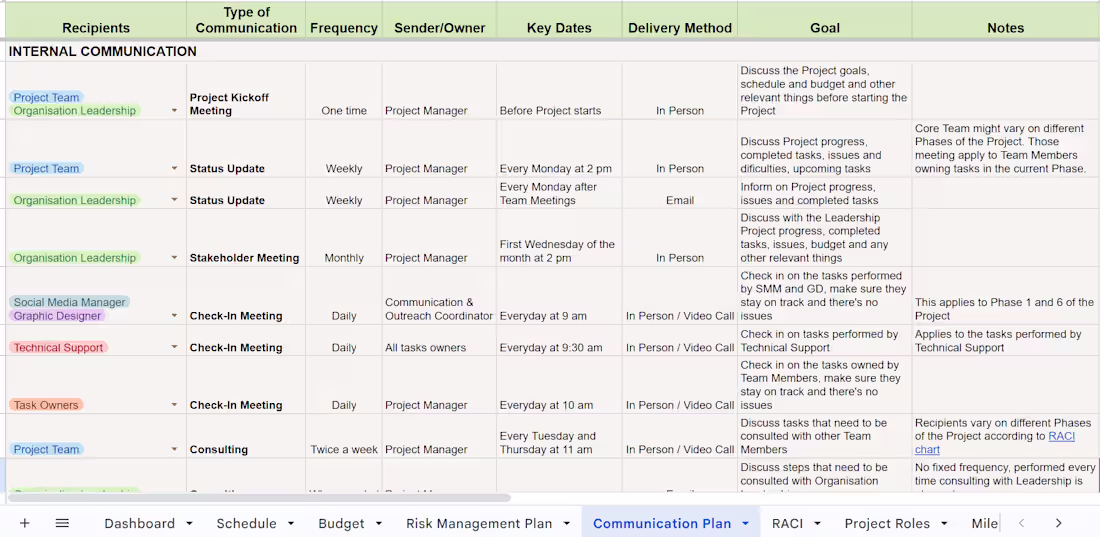

Communication Plan 📩 It doesn't seem so obvious in project planning, but it ensures everyone can stay focused on their job without thinking "Should I send this email now? Maybe the person prefers to check updates in shared documents?" Created for Work Without Bias – Corporate Anti-Discrimination Initiative. Feel free to check the whole project here: https://www.dominikatomczak.com/projects/work-without-bias
1
28
251
20

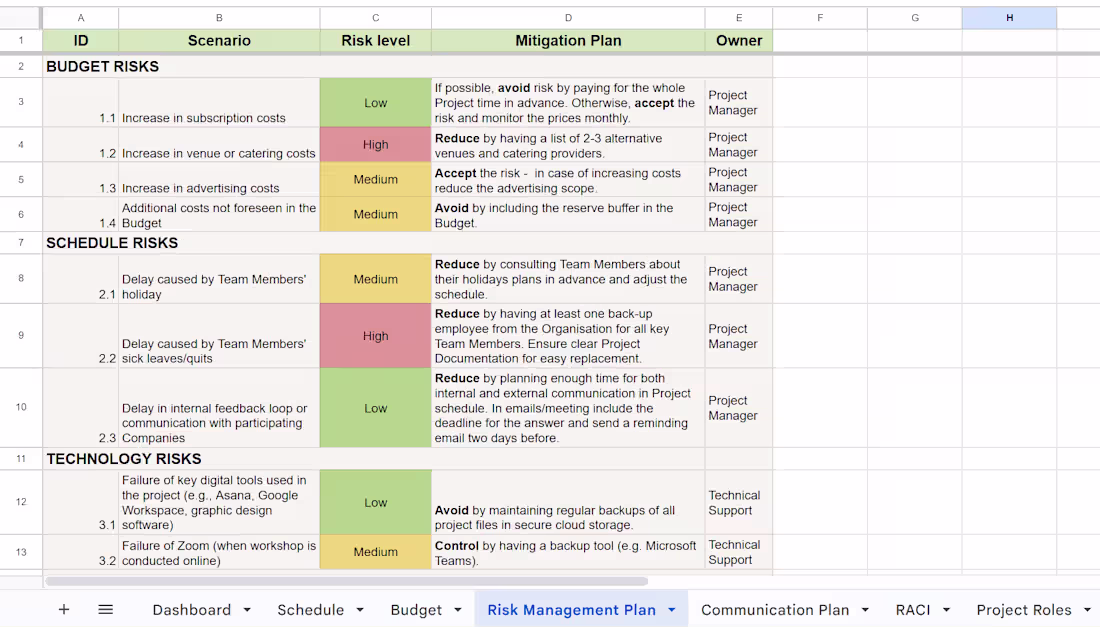

Risk Management Plan ⚠️ A list of risks with their level and mitigation plan - a necessary item for smooth project delivery. Created for Work Without Bias – Corporate Anti-Discrimination Initiative. Feel free to check the whole project here: https://www.dominikatomczak.com/projects/work-without-bias
20
226
25

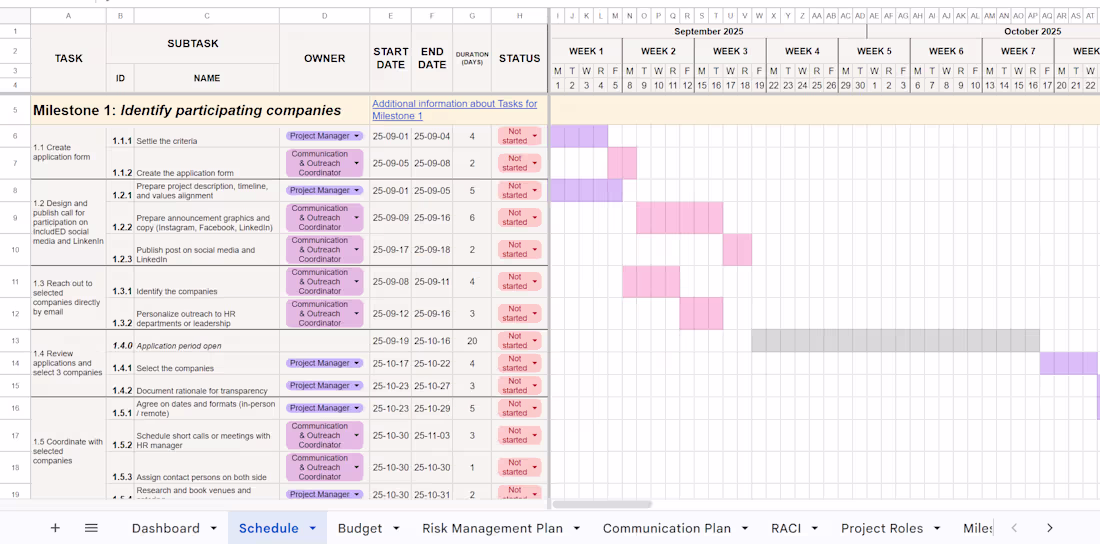

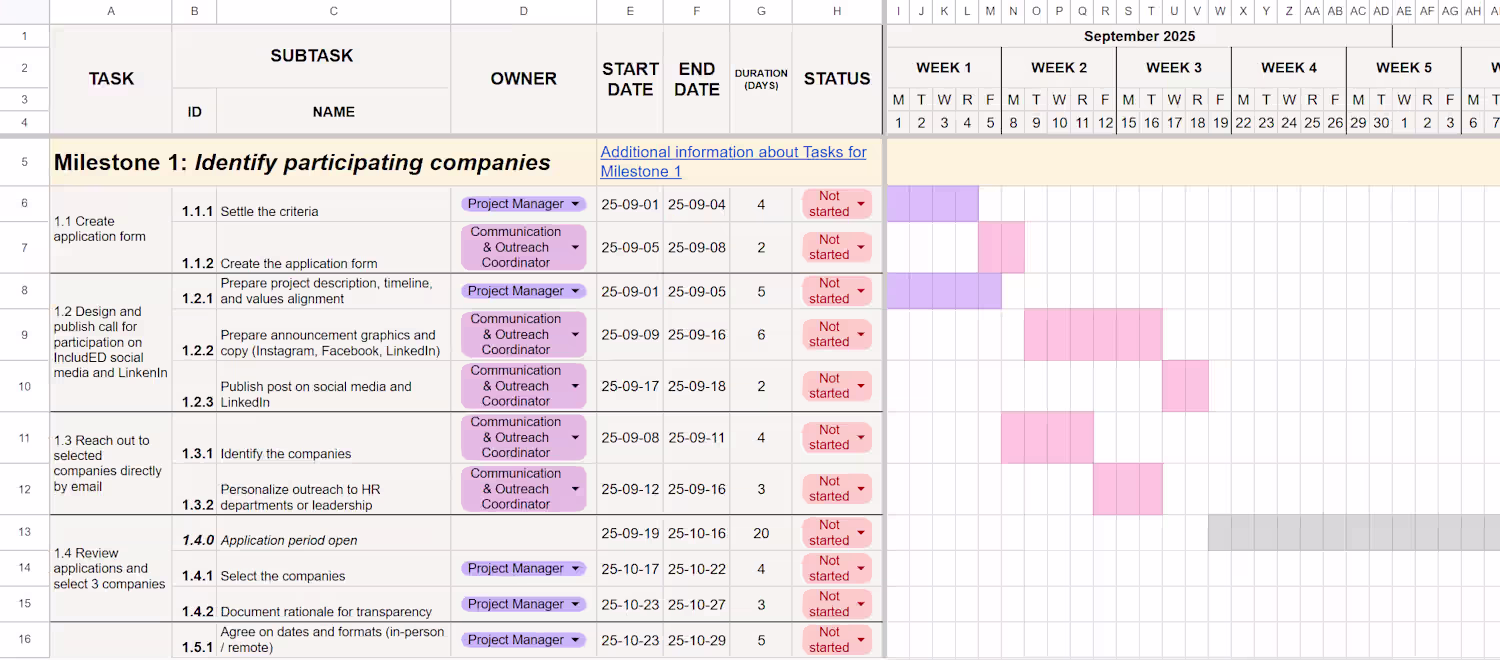

Project Timeline 📋 Detailed project timeline for Work Without Bias – Corporate Anti-Discrimination Initiative. Gantt chart is definitely one of my favorite tools to manage projects. Task assignments, schedule, team management - all in one, visually pleasing sheet, love it! Feel free to check the whole project here: https://www.dominikatomczak.com/projects/work-without-bias
25
231
15

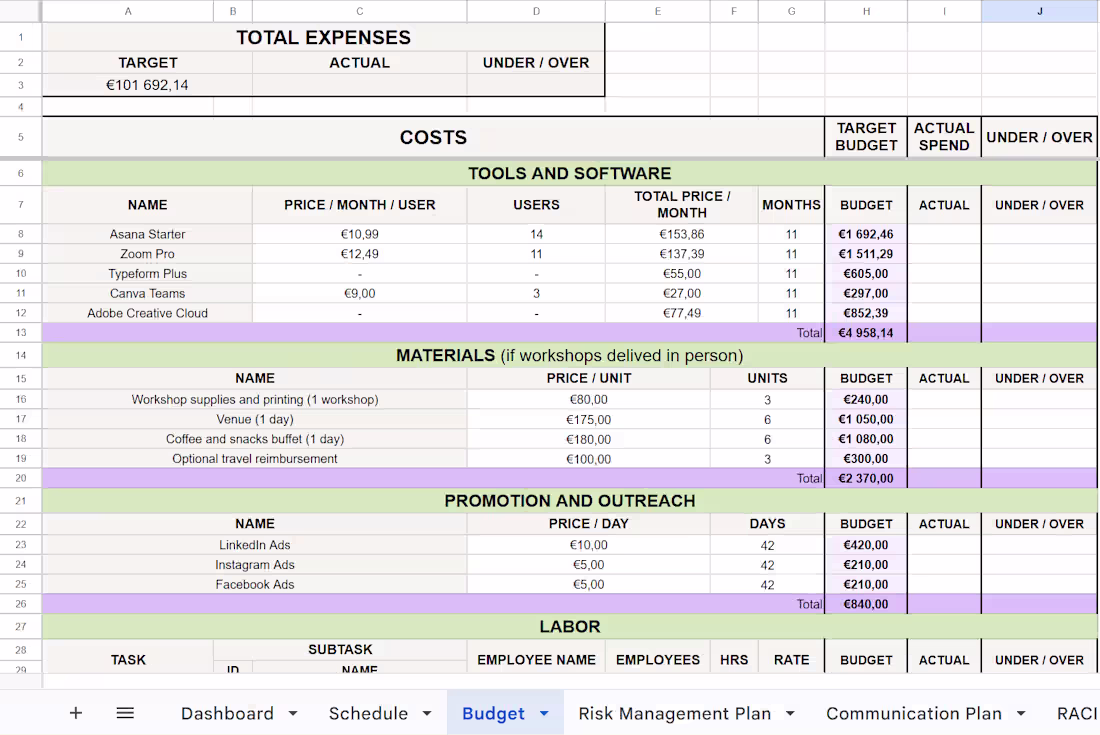

Budget Plan 💸 Detailed budget plan for Work Without Bias - Corporate Anti-Discrimination Initiative. Feel free to check the whole project: https://www.dominikatomczak.com/projects/work-without-bias
1
15
165
